All Article

Cost Variance Explained: Definition, Formula, and Examples

Discover how cost variance can transform your project cost management by revealing whether you're on budget, over budget, or under budget with clear insights and practical examples.

8 minutes read

Understanding how to manage and track project costs is a cornerstone of successful project management. One critical metric that helps project managers stay on top of their budgets is cost variance.

This blog post will break down what cost variance is, how to calculate it, why it matters, and provide real-world examples to make the concept clear. Whether you're a seasoned project manager or just starting out, mastering cost variance can make a significant difference in your project cost management efforts.

What Is Cost Variance?

Cost variance (CV) is a financial metric used in project management to measure the difference between the planned budget and the actual costs incurred at a specific point in a project. Essentially, it tells you whether you're over or under budget and by how much. This metric is a key component of cost control and is widely used in industries like construction, manufacturing, software development, and event planning.

By calculating cost variance, project managers can identify budgetary issues early, allowing them to take corrective actions before small discrepancies balloon into major financial problems. It’s a vital part of project cost tracking, ensuring that every dollar spent aligns with the project’s financial goals.

Why Cost Variance Matters

Keeping a close eye on cost variance helps project teams maintain financial discipline. A positive cost variance indicates you're spending less than planned, which is great news. On the other hand, a negative cost variance signals overspending, which could jeopardize the project’s success if not addressed promptly. By integrating cost variance into your cost management strategy, you can:

  • Identify trends in spending.
  • Pinpoint areas where costs are deviating from the plan.
  • Make informed decisions about resource allocation.
  • Improve forecasting for future projects.

Incorporating cost management software or a cost tracker can simplify this process, providing real-time insights into your project’s financial health.

The Cost Variance Formula

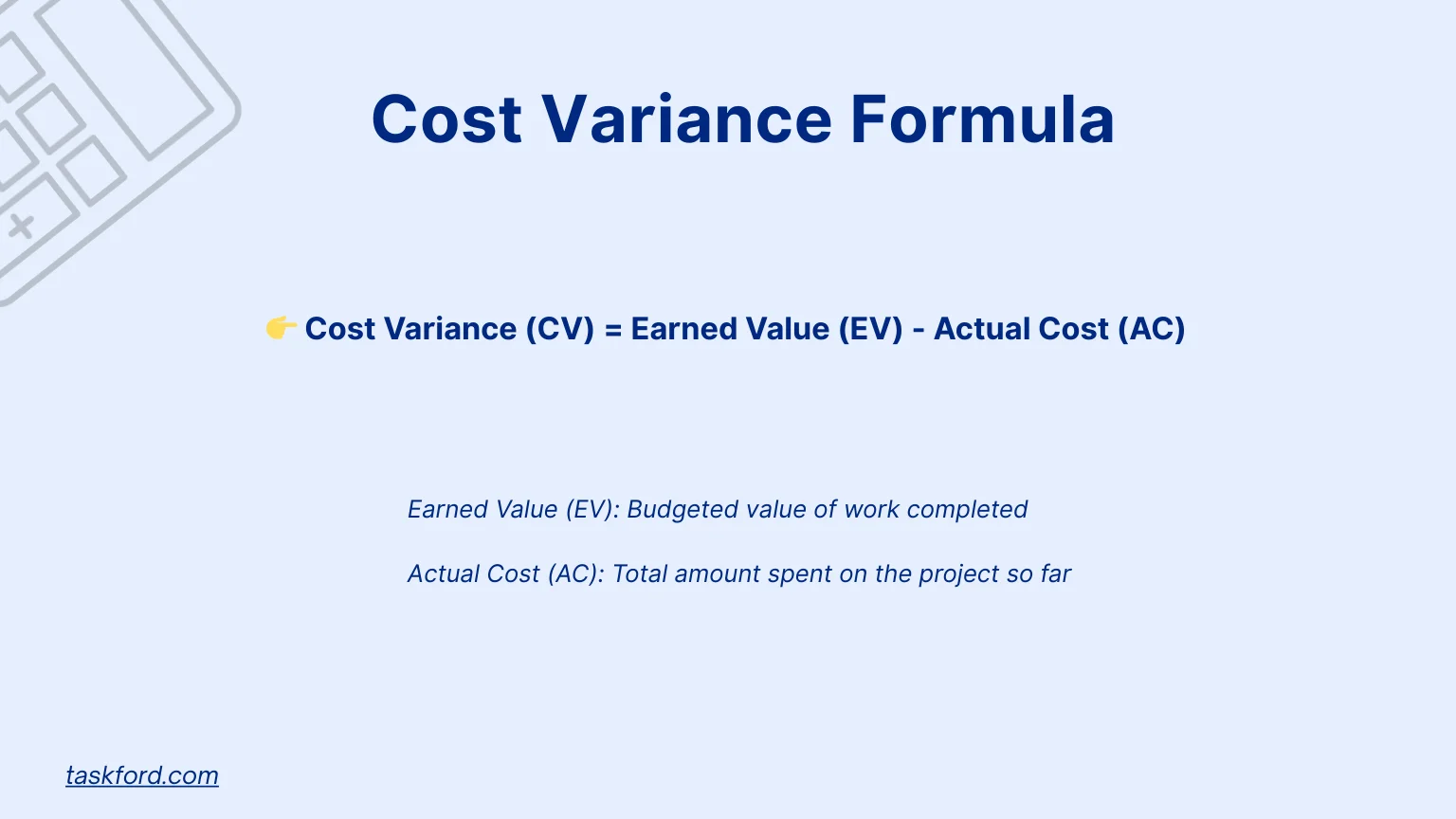

The Cost Variance Formula

To calculate cost variance, you need two key pieces of information: the Earned Value (EV) and the Actual Cost (AC). These terms come from Earned Value Management (EVM), a methodology used to assess project performance.

The formula for cost variance is:

Cost Variance (CV) = Earned Value (EV) - Actual Cost (AC)

Here’s a quick breakdown of the terms:

  • Earned Value (EV): This represents the budgeted value of the work actually completed at a given point in the project. It’s calculated by multiplying the percentage of work completed by the total budgeted cost (also called the Budget at Completion, or BAC).
  • Actual Cost (AC): This is the total amount spent on the project up to that point, including labor, materials, equipment, and other expenses.

Interpreting the Result

  • Positive CV (CV > 0): The project is under budget, meaning you’ve spent less than the value of the work completed.
  • Negative CV (CV < 0): The project is over budget, indicating that costs are exceeding the value of the work done.
  • Zero CV (CV = 0): The project is exactly on budget, with costs matching the earned value.

Understanding this formula is the first step to effective cost tracking. Tools like cost tracking software can automate these calculations, saving time and reducing errors.

How to Calculate Cost Variance: A Step-by-Step Guide

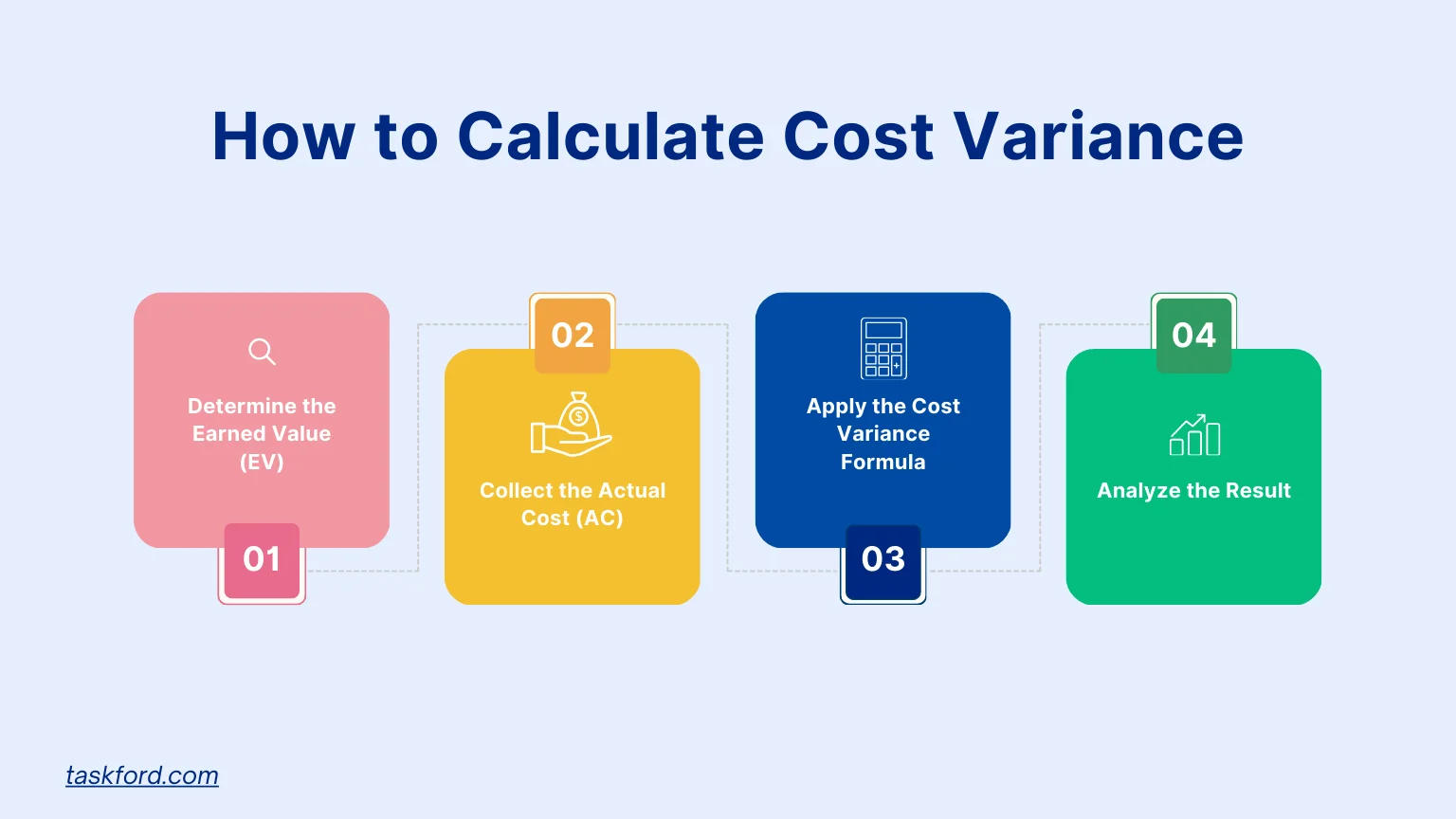

How to Calculate Cost Variance

Let’s walk through the process of calculating cost variance with a simple example to make it clear.

Step 1: Determine the Earned Value (EV)

Suppose you’re managing a website development project with a total budget of $50,000. At the halfway mark (50% completion), the planned value of the work completed should be:

EV = 50% of $50,000 = $25,000

This means the value of the work completed, according to the budget, is $25,000.

Step 2: Collect the Actual Cost (AC)

Now, check how much you’ve actually spent. Let’s say your team has spent $28,000 on developers, designers, and hosting fees up to this point.

AC = $28,000

Step 3: Apply the Cost Variance Formula

Using the formula CV = EV - AC, plug in the numbers:

CV = $25,000 - $28,000 = -$3,000

Step 4: Analyze the Result

A cost variance of -$3,000 means the project is over budget by $3,000. This signals that you need to investigate why costs are higher than planned and take corrective actions, such as renegotiating vendor contracts or reallocating resources.

By regularly performing this calculation with a cost tracker, you can stay proactive in your project cost management efforts.

Real-World Examples of Cost Variance

To make the concept of cost variance more tangible, let’s explore a few scenarios across different industries.

Example 1: Construction Project

Imagine you’re overseeing the construction of a small office building with a budget of $2 million. At the 40% completion mark, the planned value (EV) is $800,000 (40% of $2 million). However, due to unexpected increases in material costs and labor overtime, the actual cost (AC) is $900,000.

CV = $800,000 - $900,000 = -$100,000

This negative cost variance indicates the project is $100,000 over budget. To address this, you might negotiate bulk discounts on materials or adjust the project schedule to reduce overtime costs. Using cost tracking software could help you spot these issues earlier by providing real-time data on expenses.

Example 2: Software Development

In a software development project with a $200,000 budget, you’re 75% done with the coding phase (EV = $150,000). However, due to hiring specialized developers, your actual costs are $160,000.

CV = $150,000 - $160,000 = -$10,000

This negative variance suggests overspending, possibly due to higher-than-expected labor costs. You might explore options like optimizing team hours or using cost management software to track expenses more closely in future phases.

Why Cost Variance Is a Key Part of Cost Management

Cost variance is more than just a number; it’s a diagnostic tool that highlights where your project stands financially. By integrating cost variance into your project cost tracking process, you can:

  • Improve Decision-Making: Knowing whether you’re over or under budget helps you prioritize tasks and allocate resources effectively.
  • Enhance Accountability: Regular cost variance analysis encourages team members to stay mindful of spending.
  • Support Cost-Benefit Analysis: Understanding cost variance helps you weigh the financial benefits of project decisions against their costs.

For example, if a negative cost variance is due to investing in higher-quality materials, a cost-benefit analysis might show that the long-term savings or improved outcomes justify the expense. Conversely, if the variance stems from inefficiencies, you can take steps to address them.

TaskFord’s Cost Tracking Features

Effective cost tracking is essential for managing cost variance and ensuring your project stays within budget. TaskFord, a comprehensive project management and resource planning platform, offers robust cost management tools designed to simplify project cost tracking and enhance financial control. Here’s how TaskFord’s features can help you monitor and manage costs effectively, making it different from other tracking tools like Toggl Track:

  • Real-Time Cost Monitoring: TaskFord allows you to track actual and scheduled costs in real time, enabling you to compare them against your project’s budgeted amounts. This helps you quickly identify cost variances and take corrective actions to prevent budget overruns.

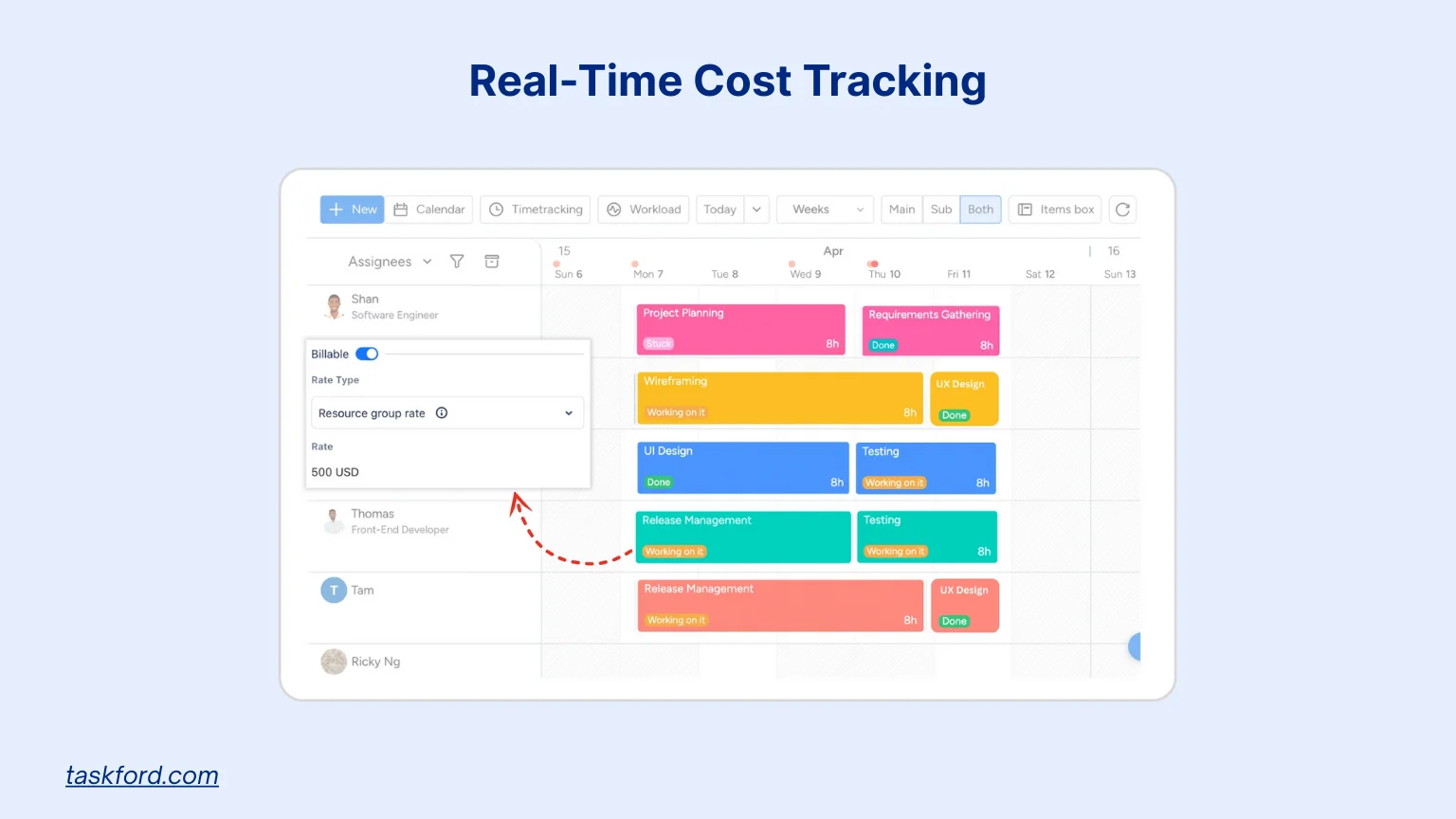

TaskFord Real-TimeCost Tracking

  • Billable Hours Tracking: With TaskFord’s cost tracking software, you can monitor billable and non-billable hours to maintain financial clarity. This feature is particularly useful for agencies and service-based businesses that need to align project costs with client invoicing.
  • Cost Planning and Comparison: TaskFord enables you to compare actual costs incurred with planned costs, providing clear insights into cost variances. This feature supports proactive budget adjustments and helps you stay aligned with your financial goals.

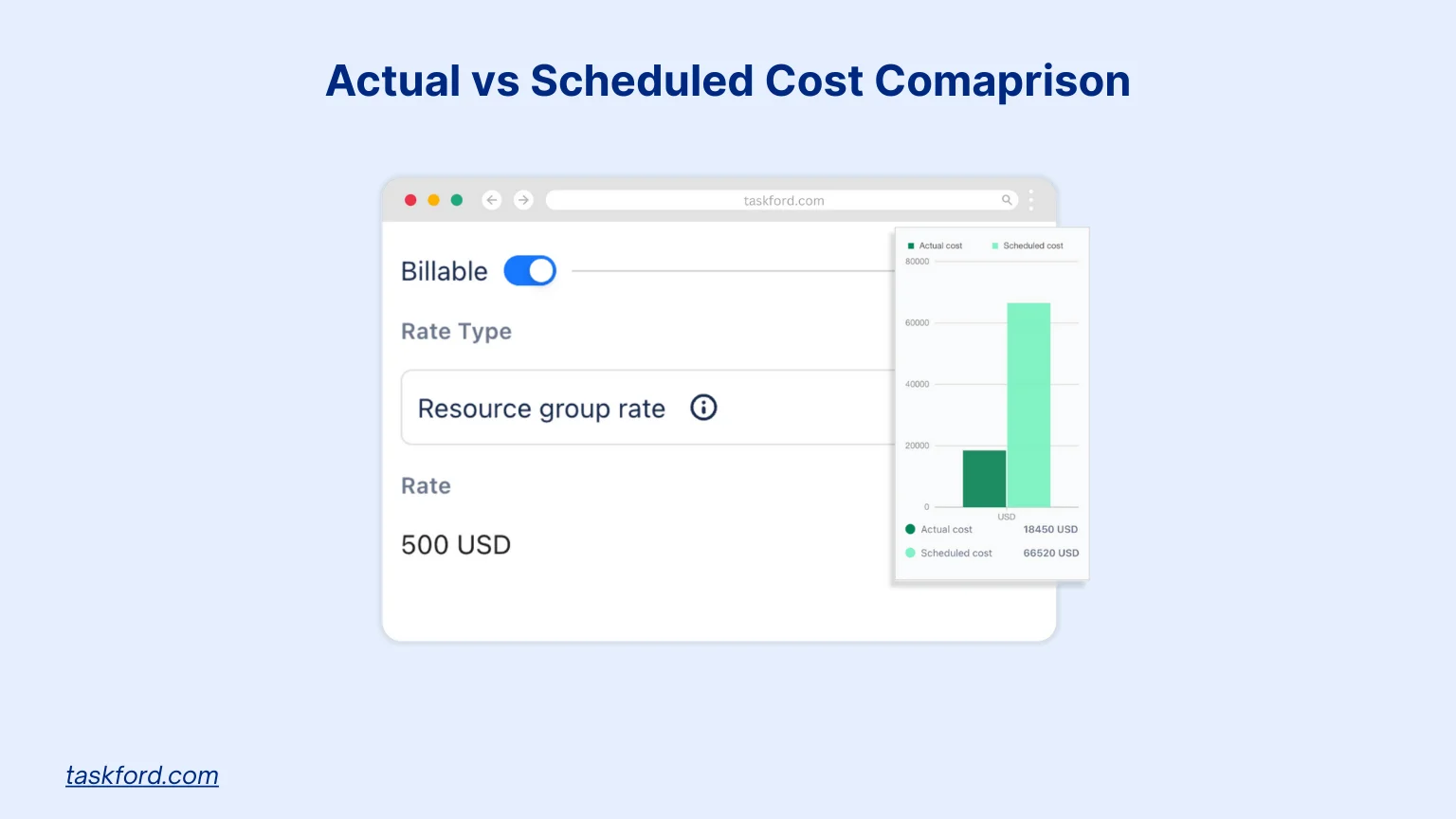

TaskFord Actual vs Scheduled Cost

  • Cost Reports for Analysis: Generate detailed cost reports to analyze cost-effectiveness and identify trends in spending. These reports are invaluable for conducting a cost-benefit analysis and making data-driven decisions to optimize project budgets.

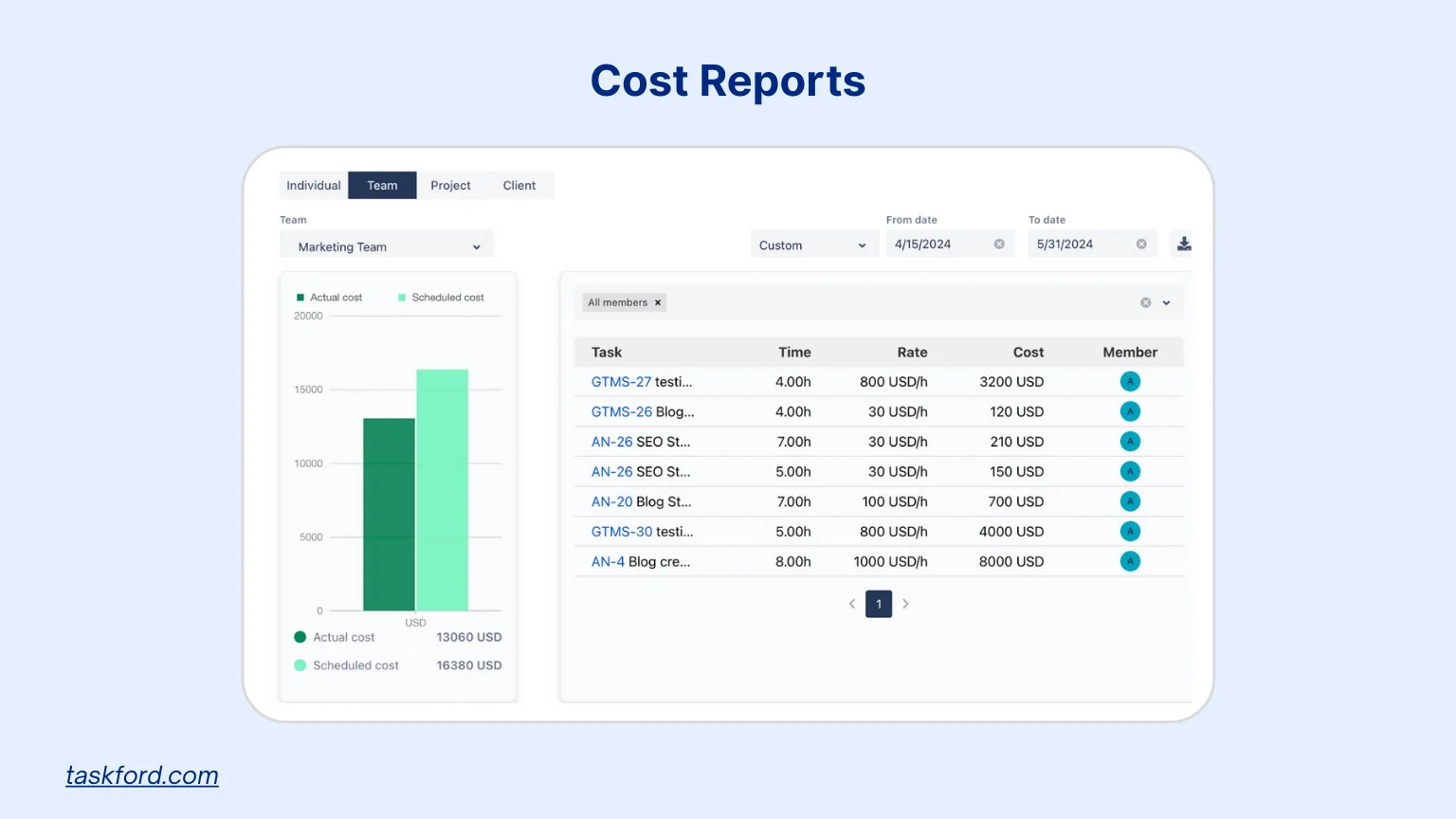

TaskFord Cost Reports

Common Causes of Cost Variance

Understanding what drives cost variance is key to preventing it. Here are some common culprits:

  • Scope Creep: Adding tasks or features not included in the original plan can increase costs.
  • Inaccurate Estimates: Underestimating labor, materials, or time requirements can lead to negative variances.
  • Market Fluctuations: Changes in material or labor costs can throw budgets off track.
  • Poor Resource Management: Inefficient use of resources, like overtime or idle equipment, can inflate costs.

By using a cost tracker, you can identify these issues early and adjust your approach to keep costs in check.

How to Address Negative Cost Variance

If you discover a negative cost variance, don’t panic. Here are practical steps to get back on track:

  1. Analyze the Cause: Use your cost tracking software to pinpoint where overspending occurred.
  2. Reevaluate the Budget: Determine if the budget was realistic or if adjustments are needed.
  3. Negotiate with Vendors: Seek discounts or deferred payments to reduce costs.
  4. Optimize Resources: Reallocate team members or equipment to high-priority tasks.
  5. Communicate with Stakeholders: Keep everyone informed about the variance and your plan to address it.

The Role of Cost Variance in Long-Term Success

Incorporating cost variance into your project cost management strategy isn’t just about fixing immediate issues; it’s about building a foundation for long-term success. By consistently monitoring cost variance, you can:

  • Improve budgeting accuracy for future projects.
  • Build trust with clients and stakeholders by demonstrating financial responsibility.
  • Identify patterns in spending that can inform better resource planning.

Using tools like TaskFord ensures you have the data you need to make these improvements.

Conclusion

Cost variance is a powerful tool for keeping your projects financially on track. By understanding its definition, mastering the formula, and applying it to real-world scenarios, you can take control of your project’s budget and avoid costly surprises. Whether you’re managing a construction site, planning an event, or developing software, cost tracking and cost control are essential for success.

With the right tools, like TaskFord, you can monitor cost variance in real time, make data-driven decisions, and ensure your projects stay within budget. Start leveraging cost variance today to boost your project cost management and achieve better financial outcomes.

Learn more

Making work simpler,
smarter, and more connected

Join our waitlist and be notified first.

Blog CTA

Subscribe for Expert Tips

Unlock expert insights and stay ahead with TaskFord. Sign up now to receive valuable tips, strategies, and updates directly in your inbox.
