Forward Pass and Backward Pass in CPM: Learn the key differences and how to calculate task timings for efficient project scheduling.
Staying on schedule is one of the biggest challenges in project management. That’s where the Critical Path Method (CPM) helps. It highlights the most critical tasks in your project—those that must be completed on time to prevent delays.
At the heart of CPM are the Forward Pass and Backward Pass. The Forward Pass helps you figure out the earliest start and finish times for each task. The Backward Pass tells you the latest times tasks can start without pushing back the project.
In this blog, we’ll explain how both passes work, how they fit together, and how you can use them to create better project schedules. We’ll also cover how to calculate float (or slack time) to give you some flexibility. Whether you're new to project management or want to improve your scheduling, this guide will help.
The Forward Pass is a key step in the Critical Path Method (CPM) used to calculate the earliest start and earliest finish times for each task in a project.
Here’s how it works:
The Forward Pass helps you map out the earliest possible timeline for your project, showing when each task can start and finish. It’s the first step in determining how long your project will take.
(For a deeper dive into the Forward Pass and its role in project management, check out our complete guide on the Forward Pass Project Management.)
The Backward Pass is the process of calculating the latest start (LS) and latest finish (LF) times for each task in a project. It helps determine the latest possible times that activities can start and finish without delaying the overall project.
Its primary purpose is to identify how much flexibility (or float) exists in the schedule by calculating the latest times tasks can begin and end while still meeting the project deadline.
(LS): LS = LF - Duration

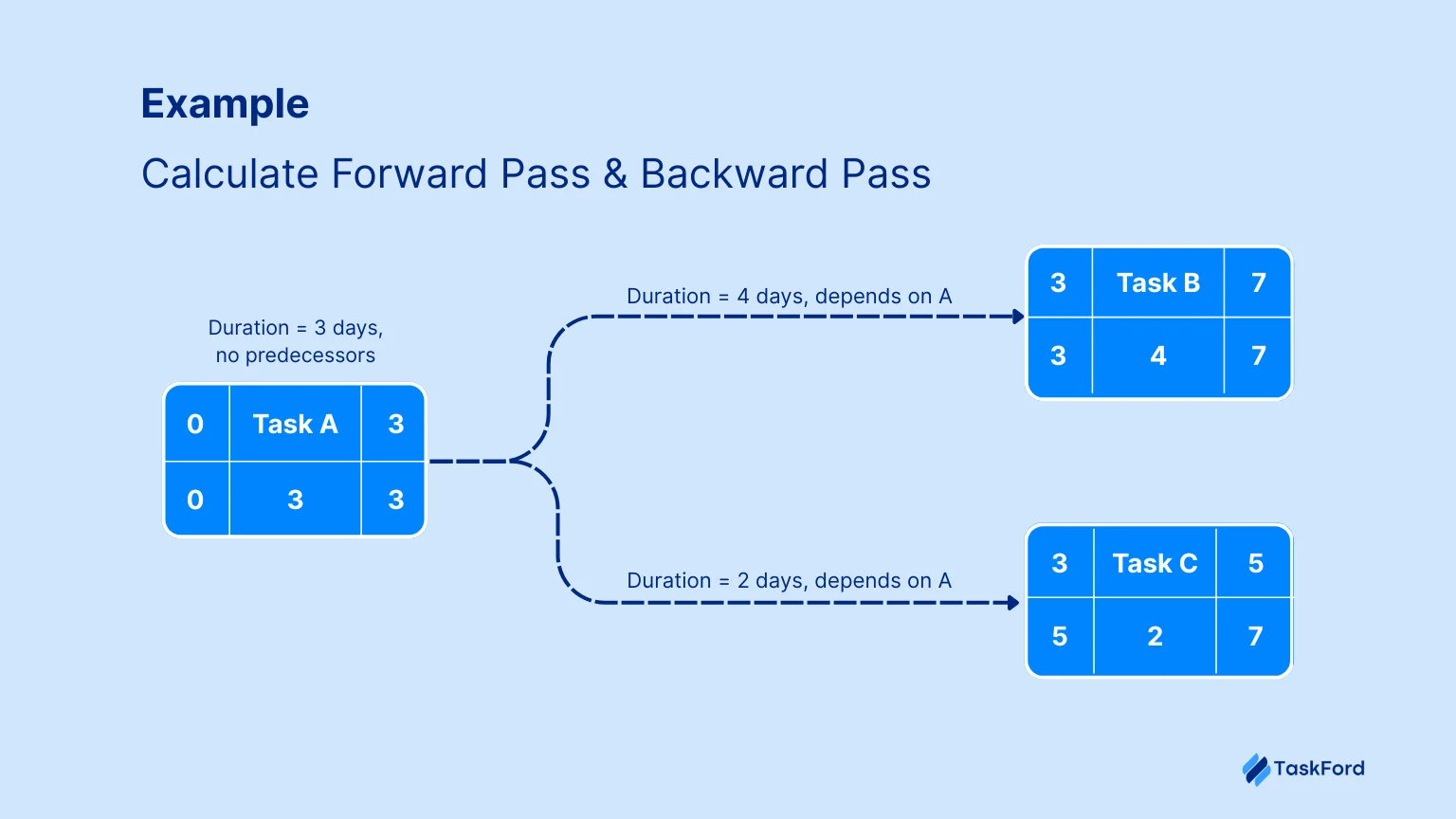

Using the same project from the forward pass example:
Forward Pass Results:
→ Forward pass results: EF of A = 3, EF of B = 7, EF of C = 5, project completion = 7 days.
Backward Pass Calculation:
The forward pass and backward pass are essential calculations in the Critical Path Method (CPM) for project planning, each serving distinct purposes in determining project timelines and flexibility. Below are the key differences between the two:
Aspect | Forward Pass | Backward Pass |
---|---|---|
Direction | Start to end | End to start |
Focus | Earliest possible times (ES, EF) | Latest allowable times (LS, LF) |
Outputs | Early Start (ES), Early Finish (EF) | Late Start (LS), Late Finish (LF) |
Purpose | Determines project duration and critical path | Identifies float and confirms critical path |
The forward pass and backward pass in the Critical Path Method (CPM) work together to create a clear, practical project schedule.
Example: In a 7-day project, the Forward Pass establishes the critical path, and the Backward Pass identifies available float for non-critical tasks, allowing for better resource allocation and efficient scheduling.
Float (or slack) is the amount of time a task can be delayed without affecting the project’s overall completion date. It helps project managers identify which tasks are flexible and which ones are critical to the timeline.
(For more details on Float/Slack, check out our comprehensive guide on Float in project management)
Key Terms:
Formula for Float/Slack:
Float = LS - ES or Float = LF - EF
→ This calculation reveals how much time a task can be delayed before affecting the project deadline.
Consider the following project tasks:
Activity | Duration | ES | EF | LS | LF |
---|---|---|---|---|---|
A | 3 days | 0 | 3 | 0 | 3 |
B | 4 days | 3 | 7 | 3 | 7 |
C | 2 days | 3 | 5 | 3 | 5 |
For Activity A:
For Activity B:
For Activity C:
In this example, all tasks have 0 float, meaning any delay will push the project completion date. There’s no room for flexibility, and every task is critical.
To ensure precise forward and backward pass calculations in the Critical Path Method (CPM), follow these practical tips:
These tips will help ensure your CPM calculations are accurate and that the project stays on track.
The Forward Pass and Backward Pass are crucial for creating an accurate project schedule. The Forward Pass sets the earliest start and finish times, while the Backward Pass ensures tasks are completed on time by calculating the latest start and finish times.
By calculating float and slack, you can identify flexible tasks and prevent delays. Regular updates and collaboration with stakeholders ensures your project stays on track and on schedule.
