Learn how to measure and track Sprint Velocity accurately in Agile projects to improve planning, forecasting, and team performance.
Measuring sprint velocity is one of the simplest yet most powerful ways Agile teams can forecast their work and improve delivery predictability. At its core, sprint velocity tells you how much work your team can complete in a single sprint — but getting that number right isn’t always as straightforward as it seems. Inaccurate measurements can lead to unrealistic commitments, missed deadlines, and unnecessary stress for the team.
In this guide, we’ll break down what sprint velocity really means, why accuracy matters, and the exact steps to measure it correctly. Whether you’re new to Agile or looking to fine-tune your team’s metrics, you’ll walk away with practical tips and examples to track sprint velocity with confidence.
Sprint Velocity is an Agile metric that represents the amount of work a team can complete during a single sprint. It’s most often measured in story points, which are units used to estimate the effort required to complete tasks in the sprint backlog.
The calculation is straightforward: at the end of a sprint, you total the story points for all fully completed work items – only those meeting the team’s Definition of Done count toward Sprint Velocity.
For example:
If your team completes three user stories worth 8, 5, and 13 story points, your Sprint Velocity for that sprint is 26 story points.
Sprint Velocity isn’t about speed for speed’s sake — it’s a planning tool. By tracking velocity over several sprints, teams can forecast future capacity, make more realistic commitments, and maintain a sustainable pace. It also provides valuable insight into trends, such as whether a team’s output is stabilizing, increasing, or declining over time.
Understanding how a sprint works is essential before diving deeper into Sprint Velocity. You can learn more in our detailed guide: Agile Project Management Sprint?
Accurate Sprint Velocity measurement is the foundation of effective Agile planning. When you know exactly how much work your team can deliver in a sprint, you can make realistic commitments, set achievable goals, and maintain a sustainable pace.

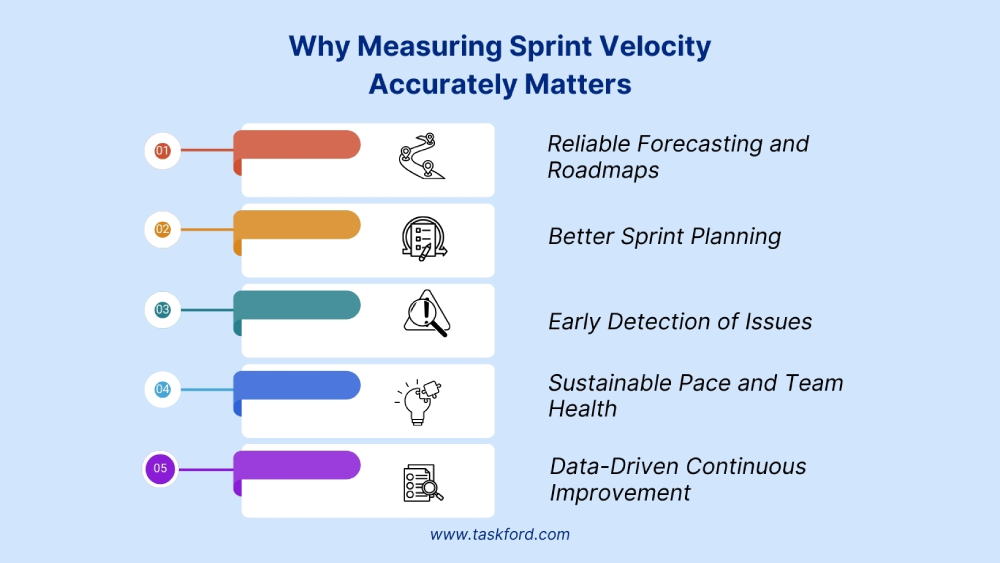

Here’s why it matters:
In short, measuring Sprint Velocity accurately ensures you’re making decisions based on reality, not guesswork. It’s one of the simplest ways to bring clarity, predictability, and confidence to Agile delivery.

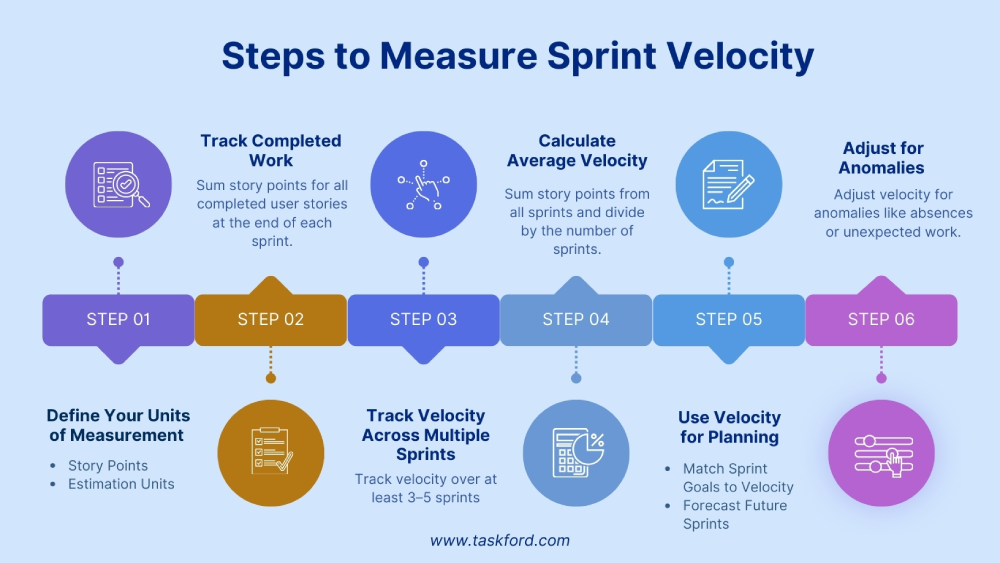

Measuring Sprint Velocity is straightforward, but accuracy depends on a consistent process. Follow these steps to ensure your numbers truly reflect your team’s capacity:
Before you track Sprint Velocity, decide how your team will estimate work.
Example Story Point Scale:
Tip: Pick one method and stick with it — changing estimation units mid-project makes velocity data unreliable.
The key to accurately measuring Sprint Velocity is to only count fully completed work. This means that at the end of each sprint, you should tally the story points for all items that meet your team’s Definition of Done (DoD).
What is the Definition of Done? Your Definition of Done is a shared understanding within the team about what constitutes a "finished" task. It ensures consistency and clarity so that everyone knows when a task is truly complete and ready for delivery. For instance:
Learn more details about the Definition of Done
A single sprint’s velocity doesn’t give a complete picture. Sprint velocity can fluctuate based on factors like task complexity, team availability, and blockers. To get a reliable measure, track velocity over at least 3–5 sprints. This accounts for natural variations and better reflects your team’s capacity.
Once you’ve tracked completed story points for multiple sprints, calculate your average Sprint Velocity. This gives you a more accurate measure of your team’s capacity for future planning.
How to Calculate Average Velocity:
Example Calculation:
Sprint | Completed Story Points |
---|---|
Sprint 1 | 24 points |
Sprint 2 | 28 points |
Sprint 3 | 22 points |
Sprint 4 | 30 points |
Average Velocity = (24 + 28 + 22 + 30) ÷ 4 = 26 points
Your average Sprint Velocity is 26 points, which you’ll use for forecasting and sprint planning.
With your average Sprint Velocity, you can now make more informed decisions about future sprints.
How to Use Velocity for Planning:
Example: If your backlog has 130 points and your average velocity is 26 points, you can estimate 130 ÷ 26 = 5 sprints to complete it.
Tip: Keep in mind that velocity can vary based on factors like team changes or unplanned work, so adjust your planning accordingly.
While Sprint Velocity is a powerful metric, it’s important to account for any anomalies or unique circumstances that may skew your data. These could include:
How to Adjust for Anomalies:
Example: If Sprint 3 had a velocity of 15 points due to unexpected blockers (e.g., a server outage), you may decide to exclude it from the average and only use Sprint 1, Sprint 2, and Sprint 4 for planning.
By adjusting for anomalies, you ensure that your Sprint Velocity remains a reliable and actionable metric for future planning and forecasting.
Visualizing Sprint Velocity can make it easier to spot trends, track progress, and communicate performance to stakeholders. Charts and graphs allow teams to quickly see how their velocity changes over time, identify patterns, and adjust strategies for future sprints. Below are some effective ways to visualize Sprint Velocity:

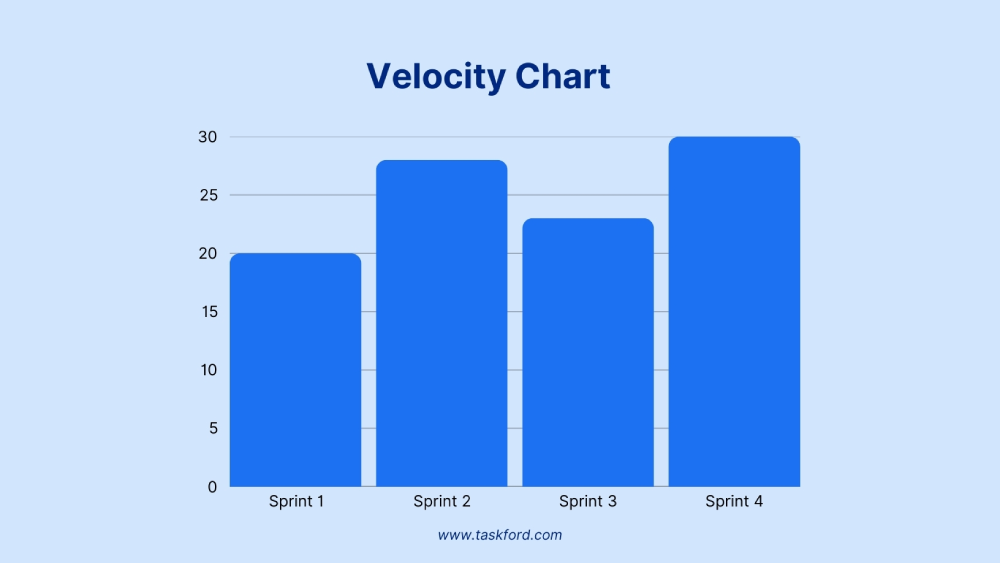

A Velocity Chart is one of the most common and useful visualizations in Agile. It displays the story points completed by the team in each sprint and can help you track how consistent your team’s velocity is across sprints.
How it Works:
A Burnup Chart is another useful visualization for tracking Sprint Velocity over time, especially when planning project milestones or releases.
How it Works:
A Burndown Chart is one of the most widely used tools in Agile to track the progress of a sprint. It shows how much work remains to be done, helping teams visualize their progress toward completing the sprint goals.
How it Works:
The chart starts with the total story points (or effort units) at the beginning of the sprint and "burns down" as work is completed. The goal is to see the line gradually approach zero as the sprint progresses.
Learn more about BurnUp vs BurnDown Chart: Which Agile Chart Is Right for Your Project?
Tracking Sprint Velocity is crucial for effective Agile planning, helping teams predict their capacity, streamline workflows, and deliver consistently. By following a reliable process — from defining estimation methods to adjusting for anomalies — you ensure that your velocity data is accurate and actionable.
When used correctly, sprint velocity aids in better forecasting, improves team performance, and keeps your projects on track without overcommitting. Ultimately, it’s about achieving predictability, sustainable pacing, and delivering value.
