All Article

Lead and Lag Time in Project Management: Key Concepts and Calculation Methods

Learn about lead and lag time in project management, how to calculate them, and their importance in optimizing project schedules and timelines

8 minutes read

In project management, timing is everything. A well-structured schedule depends on how tasks connect, overlap, or wait for one another. This is where lead and lag time become critical. These two concepts help project managers define task dependencies more precisely, ensuring that work progresses in the right sequence without unnecessary delays.

By understanding lead and lag time, you can spot opportunities to speed up project delivery, account for realistic waiting periods, and keep the overall timeline under control. Whether you’re planning a software launch, coordinating a construction project, or managing a marketing campaign, these techniques play a crucial role in ensuring accurate and achievable schedules.

In this article, we’ll explain what lead and lag time are, highlight their key differences, walk through calculation methods, and share practical applications to help you apply them effectively in your projects.

What is Lead Time in Project Management?

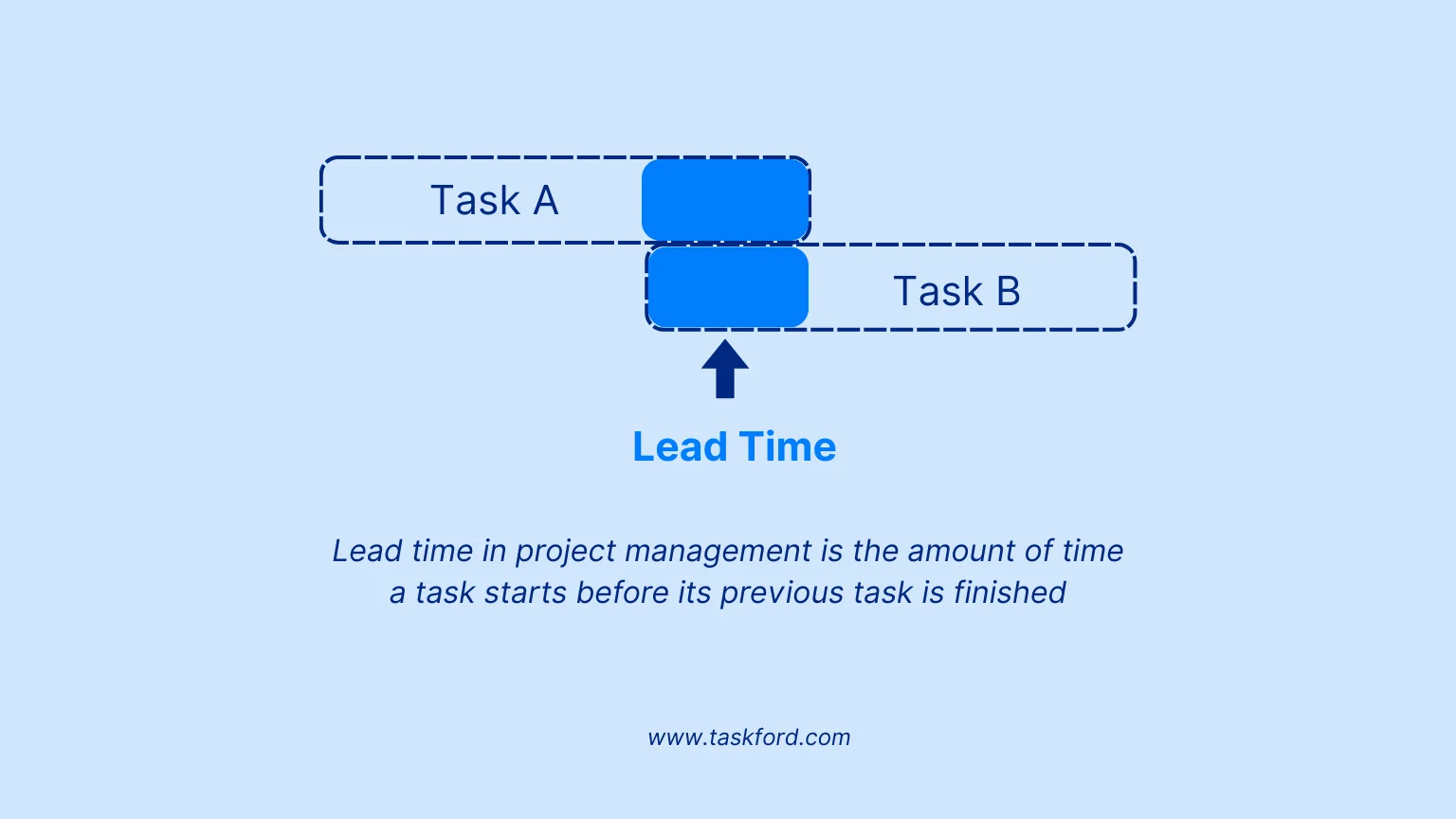

Lead time in project management refers to the amount of time that can be shortened between two dependent tasks. Essentially, it’s the time overlap that allows one task to start before another has fully completed. This helps to speed up the overall project timeline by enabling activities to run concurrently rather than sequentially.

What are Lead Time & lag time in Project Management?

For instance, in software development, testing can begin before coding finishes, speeding up the timeline. Lead time is used in task relationships like Finish-to-Start (FS) or Start-to-Start (SS) to fast-track projects while managing dependencies. However, it requires careful planning to avoid rework if the preceding task changes.

What is Lag Time in Project Management?

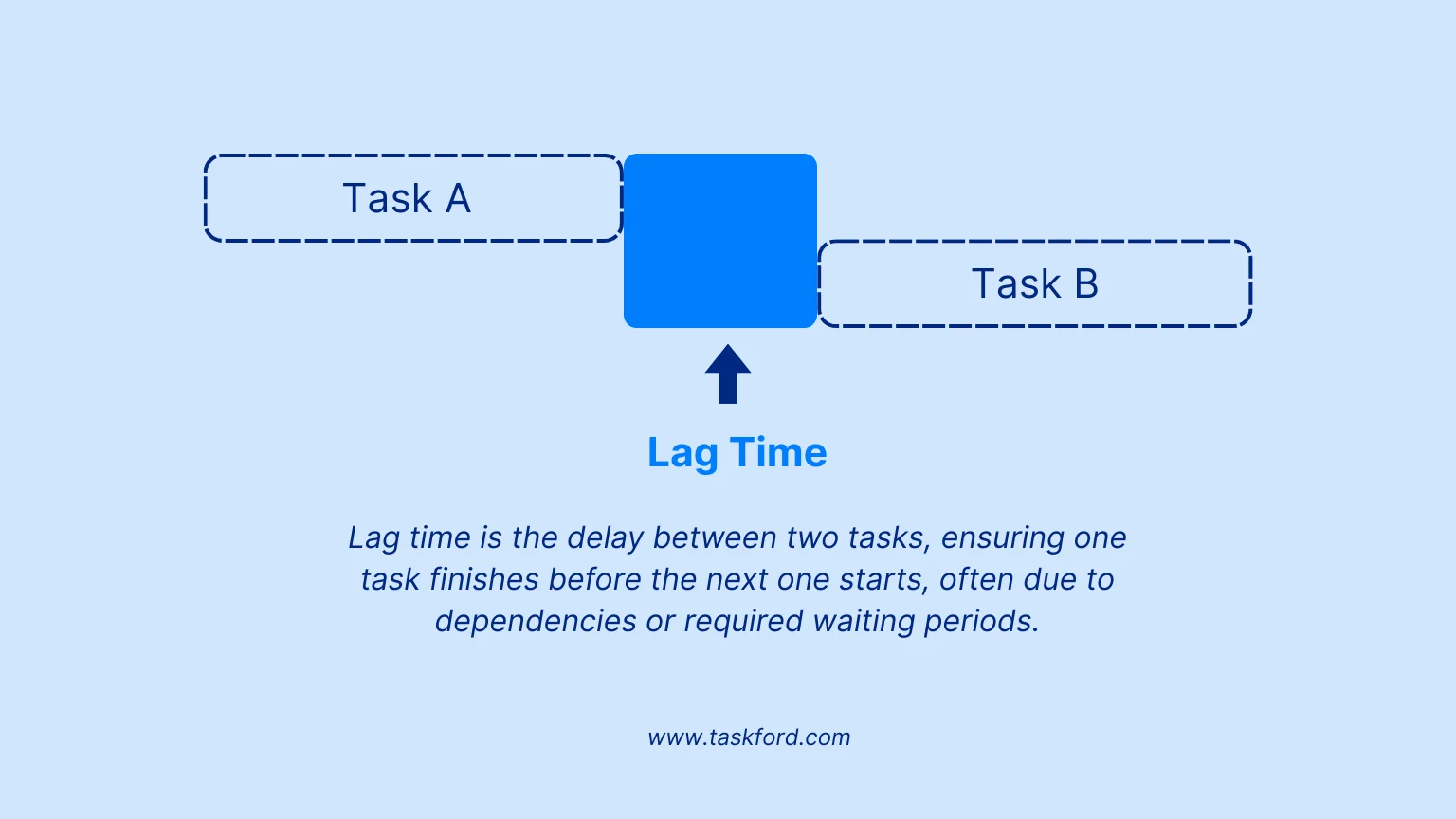

Lag time in project management refers to the required delay between two dependent tasks. Unlike lead time, which overlaps tasks, lag time ensures that one task finishes before the next one starts, adding a necessary gap.

What are Lead Time & lag time in Project Management?

For example, in construction, after pouring concrete, you must wait for it to cure before proceeding with further work. Lag time is often used in task relationships like Finish-to-Finish (FF) or Start-to-Finish (SF), helping to manage realistic project timelines and avoid conflicts.

Key Differences Between Lead and Lag Time

While both lead time and lag time relate to the sequencing of tasks, they serve different purposes and impact project schedules in distinct ways. Here are the key differences between them:

1. Purpose

  • Lead Time: Used to accelerate the project schedule by allowing tasks to overlap. This can help reduce the overall project duration when certain tasks can begin early without risk.
  • Lag Time: Used to create a necessary delay between tasks. It’s implemented when a gap is required to accommodate specific dependencies or conditions, preventing one task from starting too early.

2. Task Relationships

  • Lead Time: Commonly applied in Finish-to-Start (FS) or Start-to-Start (SS) relationships, where the subsequent task is allowed to begin before the preceding task is fully completed.
  • Lag Time: Typically used in Finish-to-Finish (FF) or Start-to-Finish (SF) relationships, where a delay is inserted between tasks to ensure the required gap before proceeding.

3. Impact on Project Duration

  • Lead Time: Helps to shorten the project timeline by overlapping tasks, allowing work to be done concurrently. This is particularly useful when tasks are independent or can be started early.
  • Lag Time: Does not shorten the project duration but ensures realistic scheduling. It prevents tasks from overlapping inappropriately and helps maintain the correct order of operations.

(Learn more: Project Duration: How to Set Realistic Project Duration Goals.)

4. Risk and Planning

  • Lead Time: While it can help accelerate project completion, improper use of lead time can lead to resource conflicts or task overlap that may affect quality or cause rework.
  • Lag Time: Typically involves fewer risks but requires careful planning to ensure that waiting periods are accurate and align with overall project constraints.

In summary, lead time speeds up the project by allowing tasks to overlap, while lag time introduces intentional delays to ensure tasks are completed in the correct order. Knowing when and how to apply each of these is crucial for effective project scheduling and management.

How to Calculate Lead and Lag Time

Calculating lead and lag time involves understanding the dependencies between tasks and adjusting their start or finish times accordingly. By managing these relationships, project managers can optimize schedules and ensure tasks are completed on time. Here’s how to calculate each:

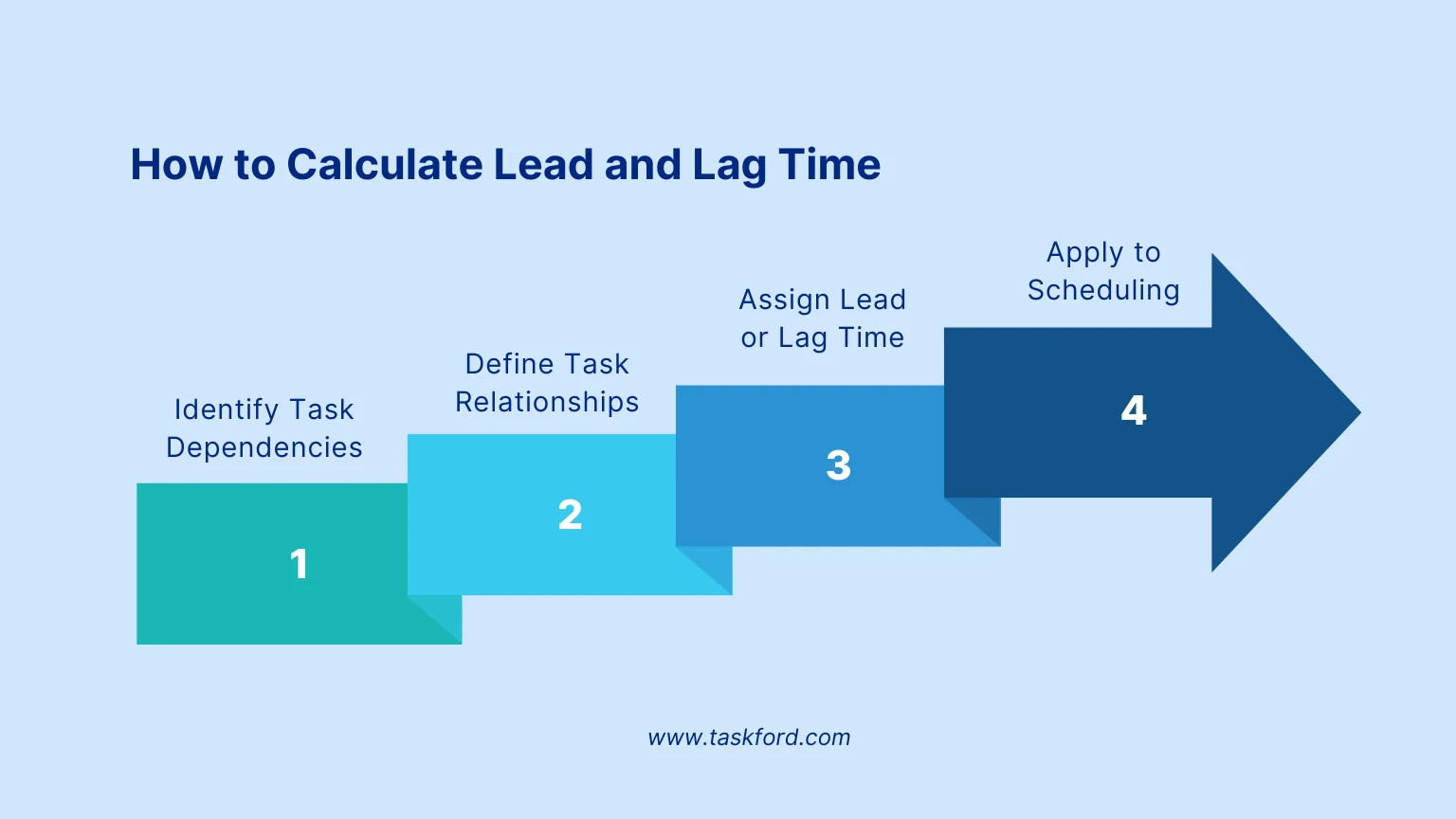

How to Calculate Lead and Lag Time

Step 1: Identify Task Dependencies

Map out tasks and their dependencies using tools like a Work Breakdown Structure (WBS), Gantt chart, or network diagram.

Example: In a construction project, "Pour Foundation" must precede "Build Walls," while "Design Interior" can overlap with "Construct Roof."

Step 2. Define Task Relationships

Determine the type of dependency between tasks:

  • Finish-to-Start (FS): Successor starts after predecessor finishes.
  • Start-to-Start (SS): Successor starts after predecessor starts.
  • Finish-to-Finish (FF): Successor finishes when predecessor finishes.
  • Start-to-Finish (SF): Successor finishes when predecessor starts (rare).

(Learn more Common Types of Gantt Chart Dependencies and When to Use Them)

Example: "Pour Foundation" and "Build Walls" have an FS relationship, while "Design Interior" and "Construct Roof" may have an SS relationship.

Step 3: Assign Lead or Lag Time

Lead Time: Specify how much earlier the successor task can start relative to the predecessor (negative value, e.g., -3 days for overlap).

  • Formula:
    • **FS: **Successor Start = Predecessor Finish - Lead Time
    • **SS: **Successor Start = Predecessor Start - Lead Time
  • Example: For "Design Interior" (SS with "Construct Roof"), a -3 days lead time allows design to start 3 days before roof construction.

Lag Time: Specifies the delay between tasks (positive value).

  • Formula:
    • FS: Successor Start = Predecessor Finish + Lag Time
    • SS: Successor Start = Predecessor Start + Lag Time
  • Example: For "Build Walls" (FS with "Pour Foundation"), a +5 days lag time accounts for concrete curing.

Step 4: Apply to Scheduling

Once lead or lag time has been assigned to tasks, the next step is to implement these adjustments into the project schedule. This can be done using project management tools or manual methods.

1. Using Project Management Software

Project management software, such as TaskFord, makes it easy to input and manage lead and lag time adjustments. In TaskFord, project managers can:

  • Inputting Dependencies: In TaskFord, you can easily define task relationships like (FS) or (SS), and specify lead or lag time for each. This helps automate the scheduling process and ensures that tasks are aligned with their dependencies.

Inputting Dependencies:

  • Auto Scheduling: The auto-scheduling feature in TaskFord automatically adjusts the start and finish dates of tasks based on the assigned lead or lag time. When you apply lead/lag time to a task relationship, TaskFord updates the schedule to reflect these changes without manual adjustments.

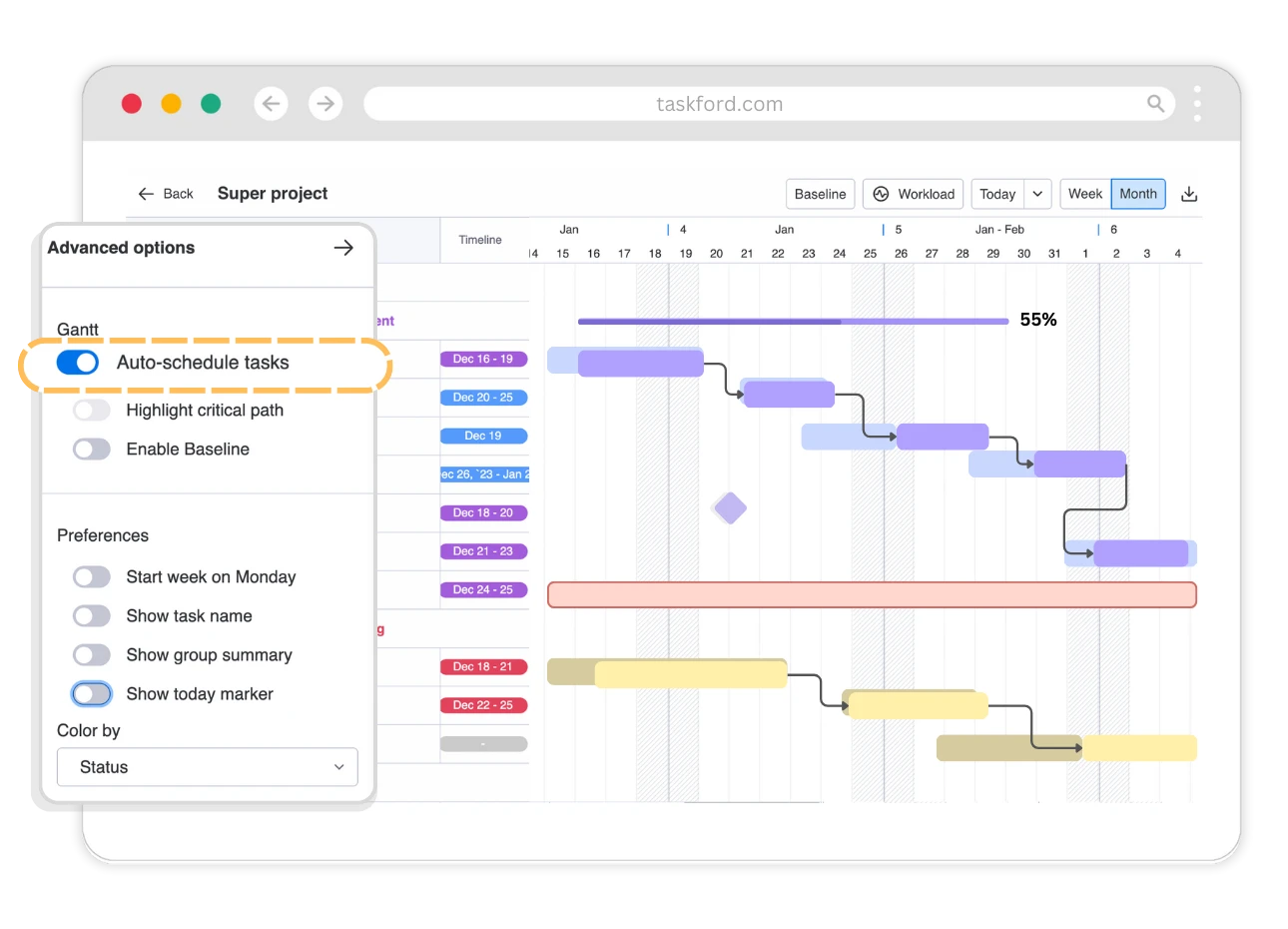

auto scheduling

  • Visualizing Timelines: TaskFord provides Gantt Charts that allow you to visualize your project timeline. The charts automatically incorporate lead and lag time adjustments, giving you a clear view of how these changes impact the overall schedule, helping you identify potential bottlenecks or overlapping tasks.

TaskFord provides Gantt charts

  • Real-Time Updates: Any changes made to tasks, such as rescheduling or adjusting dependencies, trigger real-time updates across the entire project. If a task’s start or finish date changes, the app automatically recalculates the lead and lag time, ensuring your project stays on track and all dependencies are respected.

2. Manual Adjustment with Critical Path Method (CPM)

  • If you’re working manually, use Critical Path Method (CPM) to adjust the successor task’s start date by adding (lag) or subtracting (lead) time.
  • Example: Adjust start dates in a Gantt chart based on calculated lead and lag times.

Critical Path Method (CPM)

By implementing these adjustments, you can visualize the effect of lead and lag times on your overall project timeline.

Why Lead and Lag Time Matter in Project Management

Effective scheduling is crucial in project management, and lead and lag time play a significant role in optimizing project timelines, resources, and task dependencies.

  1. Optimize Schedules: Lead time allows tasks to overlap, shortening project duration. Lag time ensures necessary delays between tasks, preventing premature starts.
  2. Better Resource Management: Lead time helps utilize resources efficiently by overlapping tasks, while lag time provides time buffers to avoid overload.
  3. Realistic Timelines: Using lead and lag time together creates more achievable schedules by accounting for both acceleration and delay.
  4. Risk Management: Lead time can help mitigate delays by starting tasks earlier, while lag time reduces the risk of rushing critical activities.
  5. Critical Path Management: Both lead and lag time help optimize the critical path, speeding up or slowing down tasks without affecting the overall project delivery.
  6. Improved Coordination: Understanding and applying lead and lag time ensures teams stay aligned and tasks are completed in the correct order.

Practical Applications of Lead and Lag Time

In project management, lead and lag time are powerful tools that help ensure tasks are properly scheduled and dependencies are managed effectively. Below are some practical applications where these concepts can be applied across different industries:

1. Software Development

  • Lead Time: In software development, testing can begin while coding is still in progress. This overlapping of tasks (lead time) speeds up the overall timeline, allowing developers to identify bugs earlier and make iterative improvements.
  • Lag Time: After testing, bug fixes may require waiting for certain approvals or updates from a different team. Lag time ensures these delays are respected before proceeding with the next task.

2. Construction Projects

  • Lead Time: In construction, certain tasks may be able to start before others are entirely finished. For example, interior design can begin while structural work is being completed.
  • Lag Time: Construction tasks often require specific waiting periods due to dependencies on materials or external factors. Curing concrete is a typical example, where work cannot continue until the foundation has set properly.

3. Marketing Campaigns

  • Lead Time: In marketing, lead time can be used to initiate preparatory work before a campaign officially begins. For instance, content creation might begin while the design phase is still ongoing.
  • Lag Time: In some cases, campaigns require waiting periods for approval or external factors (like waiting for a product release). Lag time helps ensure that no activity starts prematurely.

Conclusion

Lead and lag time are crucial tools in project management for optimizing schedules. Lead time allows tasks to overlap, speeding up project timelines, while lag time ensures necessary delays, keeping tasks in the right order. By applying these concepts, project managers can improve efficiency, manage resources better, and reduce risks, leading to more realistic and achievable project schedules. Mastering lead and lag time helps ensure projects stay on track and are delivered on time.
